- Last updated
Background
Respond to the growth of domestic power consumption, Taiwan Power Company (TPC) follows the government’s energy policy and promotes the " Datan Combined Cycle Power Plant Expansion Project" to ensure stable power supply. TPC plans to add three high-efficiency gas-fired combined cycle units at current plant site, with the total capacity of 3160MW.
In 2016, owing to the changes in the existing and the newly added power units, which could have directly led to power shortages in 2017-2019, emergency generator units were needed to be added. Based on the comprehensive assessment results of Site conditions, TPC initiated the Datan Emergency Gas Turbine Generator Project at Datan Power Plant site to relieve the tension of electric supply. The all-turkey was contracted by GE to install two gas-fired simple cycle units with a total installed capacity of 600MW..
Project Location and Scope

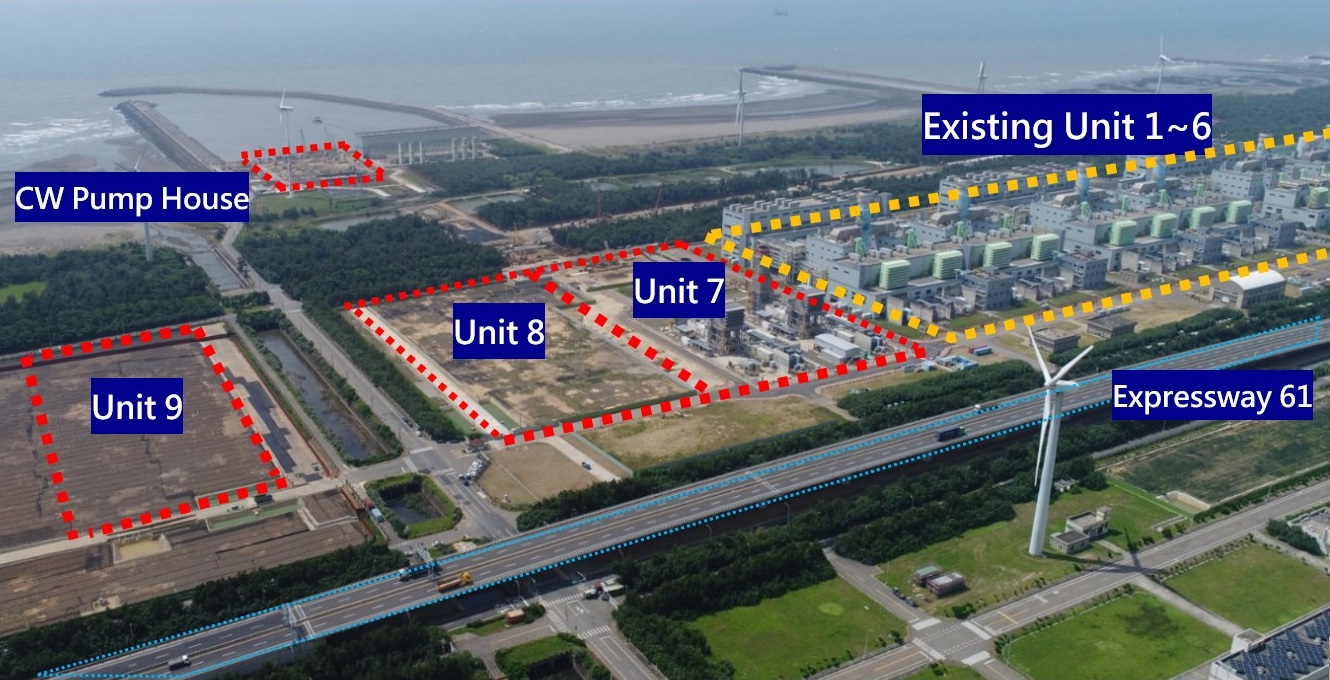

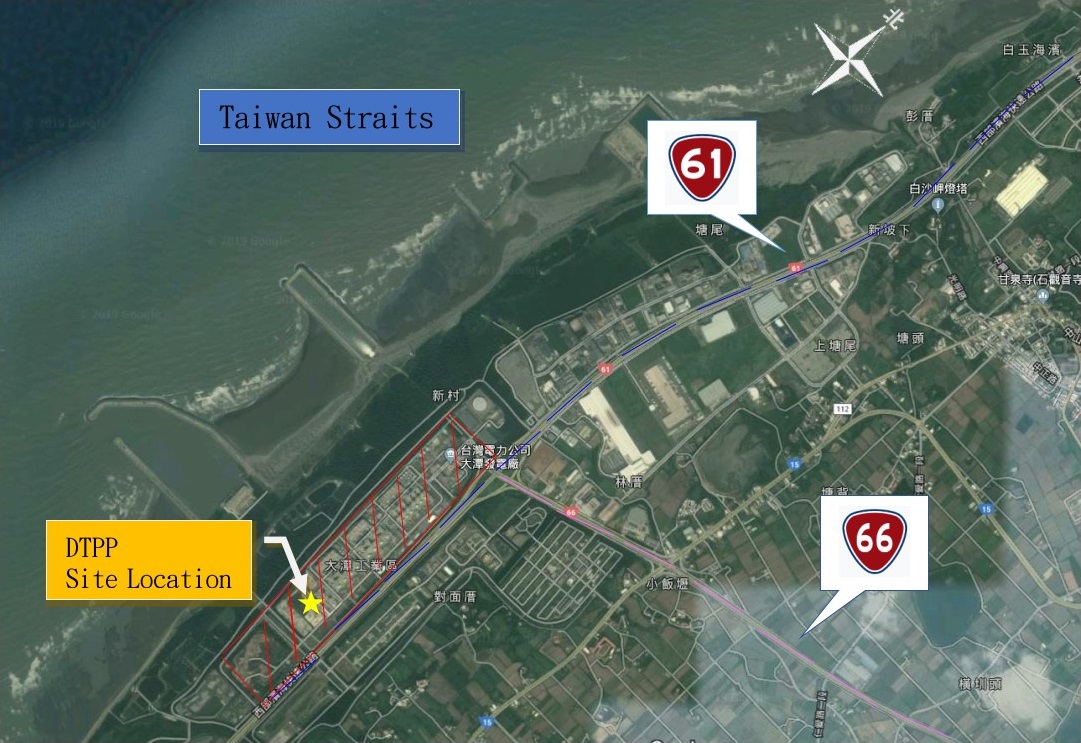

The Datan Power Plant (DTPP) is located at the Datan coastal industrial park, Guanyin District, Taoyuan City, with a length of about 2,300 m and a width of about 750 m. The total area is about 116.02 hectares. There are six combined cycle units in operation, totally 4386 MW. The project "Datan Combined Cycle Power Plant Expansion Project" will install 3 combined cycle units at the south vacant lot of DTPP approximately 19.8 hectares. Besides, TPC has completed the installation of two phase 1 gas-fired simple cycle units (300 MW per unit) at the unit 7 site with a total installed capacity of 600 MW.



New Design Units Specification
Item | Specification |
---|---|
No. of Unit | 3 (Units 7, 8, 9) |
Installed Unit Capacity | Units 8 & 9: 2247 MW Unit 7: 913 MW |
Unit Type | Combined Cycle Units (2on1) |
Net Thermal Efficiency | Above 60.7% (LHV) |
Net Heat Rate | Below 5,930kJ / kWh (LHV) |
Gas turbine | In-Door/ For Power Generation /3,600 rpm |
Heat Recovery Steam Generator | In-Door / Horizontal Gas Flow Type |
Steam Turbine | In-Door /3,600 rpm |
Generator | Hydrogen-Cooled / Three-phase Synchronous Machines / 3600 rpm |
Transformer | Outdoor Type Oil-immersed / Three-phase / 60 Hz |
Project Progress
Schedule | Actual | Difference |
---|---|---|
99.73 | 99.72 | -0.02 |
Unit 7 (Phase II) | Unit 8 | Unit 9 |
---|---|---|
2025/5/1 | 2024/7/31 | 2025/7/23 |
- The revision of the Datan Combined Cycle Power Plant Expansion Project approved by the Executive Yuan's letter No. 1121047226 on Jan. 26,2024.
- The Datan Unit 9 have been Commercial Operation Date(COD) and Obtaining Electricity Generation License on July. 23, 2025.

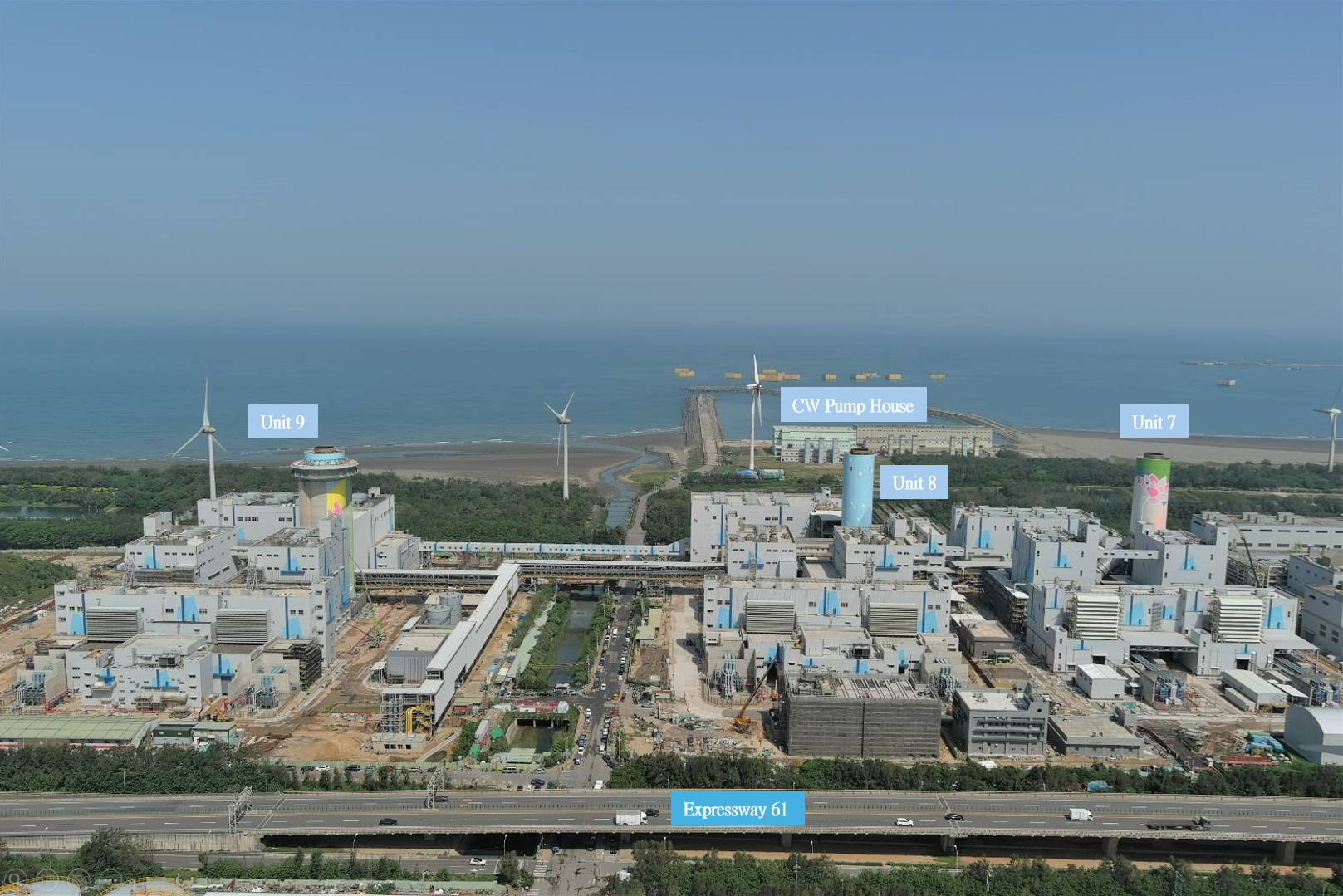

Construction Status:
-
Power Block: Unit 7 reached the official dispatch date on July,4,2025;The Energy Administration, Ministry of Economic Affairs completed the final inspection of Unit 7 on August 4, 2025.
-
Circulating Water System:
The equipment commissioning work in CWP house is ongoing. -
161kV Underground Cable from Datan to Linkou:
The item has accessed to electricity grid before end of June-2023.
-
Selective Catalytic Reduction System (SCR) used for environmental protection.
Pollutant Emission Concentration SOx 10 ppm NOx 5 ppm Particulate 10 mg/Nm3
